New Construction Inspection Timeline: Pre-Drywall, Final Walkthrough, and 11-Month Warranty Checklist

Published On

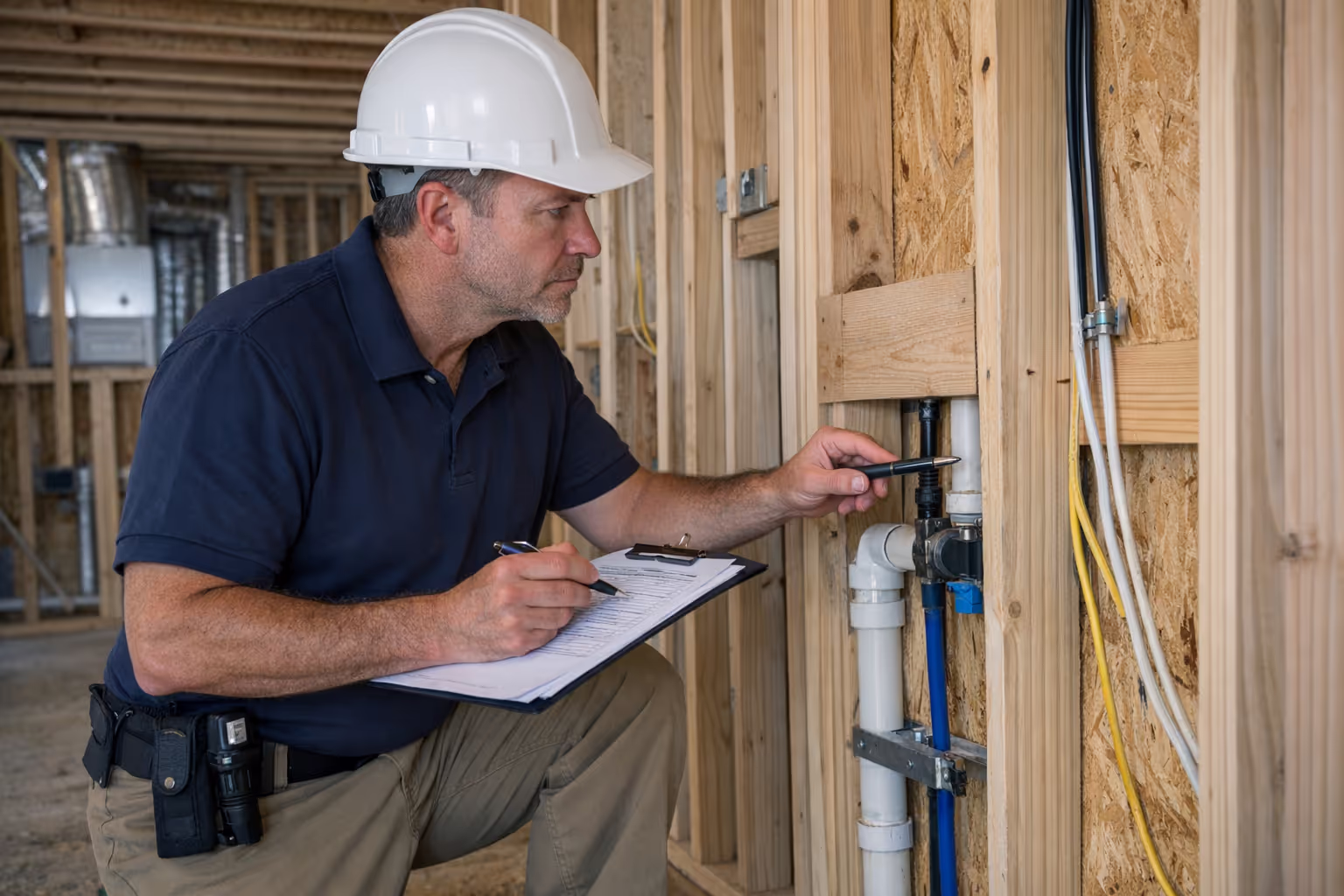

Professional inspector examining new construction home framing during pre-drywall inspection timeline phase

Last year, a buyer in Elk Grove closed on a brand-new home and discovered water pooling in the garage three months later. The culprit? A plumbing connection behind the finished wall that was never properly sealed. Fixing it meant cutting through drywall, repairing the pipe, and patching everything back together—roughly $2,800 out of pocket for something that would have taken a plumber fifteen minutes to correct before the walls went up.

That's the risk with new construction: "new" doesn't mean "flawless." Even experienced builders working with quality crews make mistakes. The difference between catching those mistakes early and inheriting them as your problem comes down to timing.

A strategic inspection timeline protects your investment at four critical milestones. Miss any of these windows, and you could discover warranty-covered defects after your coverage expires—or worse, after they've caused secondary damage.

This guide breaks down exactly when to schedule each inspection, what gets evaluated at each phase, and how to document everything so nothing falls through the cracks. You'll also find a reusable punch-list framework you can adapt for your own build.

Why New Construction Homes Still Need Independent Inspections

There's a persistent myth that new builds don't require inspections. Everything is new, the reasoning goes, so what could possibly be wrong?

Plenty, as it turns out.

The National Association of Home Builders has documented ongoing labor shortages affecting residential construction nationwide [1]. When crews are stretched thin or working under aggressive timelines, errors happen. Electrical wiring gets routed incorrectly. Plumbing connections aren't fully tightened. HVAC ductwork develops gaps at the seams. Framing members get notched beyond structural limits.

Municipal code inspections exist, but they serve a different purpose than a private inspection hired to protect your interests. City inspectors verify minimum code compliance at designated checkpoints—they're not conducting a comprehensive evaluation of your home's quality and workmanship [2].

Pro Tip from Tavon: "In the Sacramento market, I've seen buyers assume city inspections cover everything. They don't. The city inspector might spend fifteen minutes on-site checking specific code items. A private inspector hired by you will spend two to three hours documenting everything—because their job is protecting you, not checking boxes for a permit."

Think of it this way: the builder's goal is meeting code and completing the project on schedule. Your goal is ensuring the home performs well for decades. An effective new construction buyer representation helps align these goals. Those objectives overlap, but they're not identical.

The Four Critical Inspection Windows

Your new construction inspection timeline should include four distinct phases, each tied to specific build milestones:

Inspection PhaseTimingPrimary Focus
Pre-pour (foundation)Before concrete is pouredFootings, rebar placement, soil preparation
Pre-drywall (frame)After rough-ins, before drywallFraming, electrical, plumbing, HVAC
Final walkthroughBefore closingCosmetic issues, fixtures, all systems
11-month warrantyBefore warranty expiresHidden defects, settling issues

Each inspection serves a different purpose. Skipping any one creates blind spots in your protection strategy.

Phase One: Pre-Pour Foundation Inspection

The foundation is literally what everything else rests on. Once concrete is poured, correcting problems becomes exponentially more difficult and expensive.

When to Schedule

Coordinate with your builder to schedule this inspection after:

  • Excavation is complete

  • Footings are formed

  • Rebar and any required reinforcement are in place

  • Plumbing rough-in for slab (if applicable) is positioned

  • But before concrete trucks arrive

This window is often measured in days, sometimes hours. Stay in close contact with your builder's site supervisor once excavation begins.

What Gets Evaluated

A thorough pre-pour inspection examines:

Site preparation

  • Proper soil compaction

  • Correct depth of excavation

  • Adequate drainage provisions

  • Vapor barrier placement (where required)

Footing and foundation forms

  • Correct dimensions per engineering plans

  • Proper depth below grade

  • Level and square positioning

  • Adequate clearance for anchor bolts

Reinforcement

  • Rebar sizing matches specifications

  • Proper spacing and overlap at joints

  • Adequate coverage (distance from forms)

  • Chair and support placement

Embedded utilities

  • Plumbing stub-outs correctly positioned

  • Electrical conduit routing (if slab-on-grade)

  • Radon mitigation provisions (where required)

Why This Phase Matters

Foundation defects are among the most expensive problems to address after the fact. Cracks from improper reinforcement, settling from inadequate soil preparation, or misaligned plumbing stub-outs can create cascading issues throughout the home's lifespan.

In the Sacramento region, where soil conditions vary significantly across different areas, foundation preparation becomes particularly important. Expansive clay soils in some neighborhoods require different engineering approaches than the sandier soils found elsewhere.

Phase Two: Pre-Drywall Inspection

The pre-drywall inspection—sometimes called a frame inspection—is arguably the most valuable inspection you'll schedule. Once drywall goes up, critical components become invisible. Problems that would cost a few hundred dollars to fix now could cost thousands after walls are sealed.

When to Schedule

Coordinate with your builder to schedule this inspection after:

  • Framing is complete

  • Electrical rough-in is finished

  • Plumbing rough-in is finished

  • HVAC ductwork is installed

  • Before insulation is installed (ideally) or before drywall begins

Important timing note: Whether insulation is in place significantly affects what your inspector can evaluate. If insulation is already installed, some electrical and plumbing routing becomes harder to assess. Communicate with your builder about scheduling before insulation whenever possible.

You typically have a narrow window—often just a few days—between when rough-in work is complete and when the next phase begins. Stay in regular communication with your builder or site supervisor to avoid missing this milestone.

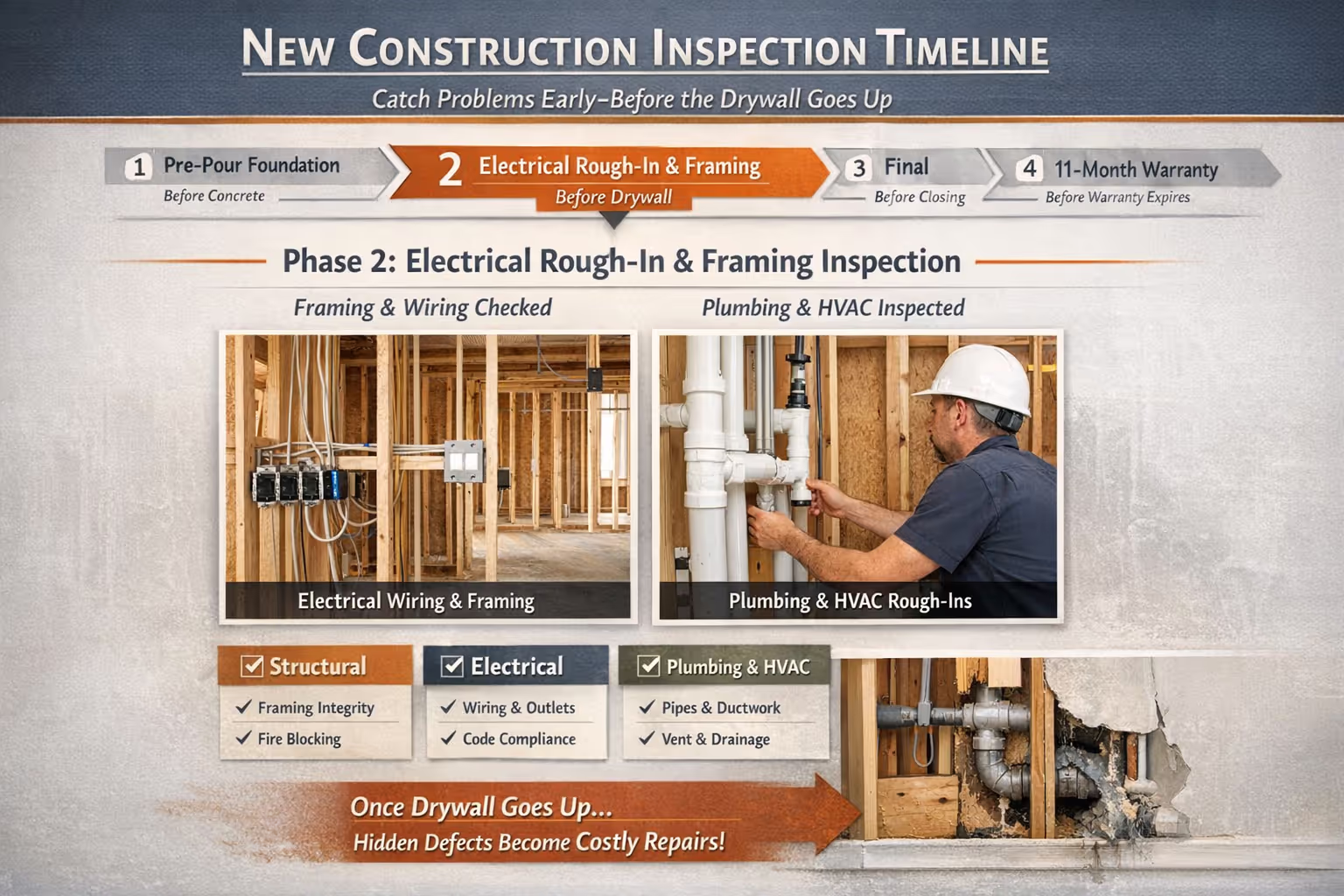

New construction inspection timeline showing electrical rough-in and framing before drywall
Pre-drywall inspections reveal critical electrical and plumbing work

What the Inspector Evaluates

A thorough pre-drywall inspection covers multiple systems:

Structural framing

  • Proper sizing and spacing of studs, joists, and rafters

  • Adequate blocking for cabinets, grab bars, and heavy fixtures

  • Correct header sizes above windows and doors

  • No cracked, warped, or damaged lumber

  • Fireblocking between floors installed correctly

Electrical systems

  • Proper wire gauge for intended circuits

  • Correct box placement and mounting depth

  • GFCI protection in required locations (bathrooms, kitchen, garage, outdoor areas)

  • Arc-fault circuit interrupter (AFCI) protection where required by current electrical codes [3]

  • Adequate clearance and protection where wires pass through framing

Plumbing systems

  • Proper pipe materials and sizing

  • Secure connections at all joints

  • Correct slope on drain lines (typically 1/4 inch per foot minimum)

  • Adequate venting configuration

  • Water hammer arrestors where needed

  • Protective plates where pipes are close to stud edges

HVAC installation

  • Ductwork properly sealed at all connections

  • Adequate duct sizing for room volumes

  • Correct refrigerant line installation and support

  • Proper condensate drainage routing

  • Return air pathways correctly configured

Insulation and moisture barriers (if accessible)

  • Correct insulation R-values for your climate zone

  • No gaps, voids, or compression in insulation batts

  • Vapor barriers installed on the correct side (climate-dependent)

  • Air sealing around penetrations

Common Pre-Drywall Issues

Here are defects inspectors frequently discover at this stage:

  • Missing fireblocking between floors (fire safety issue)

  • Electrical boxes installed too deep for proper switch/outlet mounting

  • Plumbing drain lines with insufficient slope

  • HVAC ducts with unsealed joints that will leak conditioned air

  • Framing members notched or drilled beyond allowable limits

  • Missing nail plates protecting wires and pipes near stud edges

  • Inadequate blocking for future grab bar installation in bathrooms

Pro Tip from Tavon: "When I'm working with new construction buyers in Sacramento or Elk Grove, I always emphasize getting the pre-drywall scheduled as early as possible in the build process. Builders are generally cooperative when you frame it as catching small issues before they become expensive problems—it's in everyone's interest."

Diagnostic Tools That Make a Difference

Experienced new construction inspectors often use specialized equipment beyond visual examination:

  • Moisture meters to identify unexpected moisture in framing materials

  • Thermal imaging cameras to detect air leaks, missing insulation, or HVAC ductwork issues (more useful at later stages but sometimes employed at pre-drywall)

  • Electrical testers to verify proper grounding and circuit configurations

Ask prospective inspectors what diagnostic tools they use as part of their standard process.

Phase Three: Final Walkthrough Inspection

The final walkthrough happens after construction is complete but before you sign closing documents. This is your last opportunity to identify deficiencies while you still have maximum leverage.

Timing Considerations

Schedule your final walkthrough inspection at least five to seven days before your closing date. This buffer provides time to:

  • Review the inspection report thoroughly

  • Submit repair requests to the builder with specific documentation

  • Allow the builder time to complete repairs

  • Verify completed repairs before closing

Rushing this process—or combining it with your actual closing day—eliminates your ability to negotiate effectively. If the inspection reveals significant issues, you need time to address them before you're committed.

What Gets Evaluated

At this stage, your inspector examines every accessible component:

Exterior components

  • Roof covering installation and flashing details

  • Gutter and downspout configuration

  • Siding installation, caulking, and trim work

  • Grading and drainage direction (away from foundation)

  • Garage door operation and safety reverse features

  • Driveway, walkway, and patio condition

  • Exterior electrical outlets and lighting

Interior systems

  • All electrical outlets, switches, and fixtures (functionality testing)

  • Plumbing fixtures, faucets, and water pressure at multiple locations

  • HVAC operation in both heating and cooling modes

  • Water heater installation and safety features

  • Appliance installation and basic function testing

  • Window and door operation, locks, and weather sealing

  • Smoke detector and carbon monoxide detector placement and function

Cosmetic and finish work

  • Paint quality, coverage, and touch-up needs

  • Flooring installation (transitions, edges, visible defects)

  • Cabinet alignment, door operation, and hardware

  • Countertop seams, edges, and mounting

  • Tile work, grout lines, and caulking

  • Trim and molding installation

Your Role During the Walkthrough

Don't just observe—actively participate. Bring a checklist and methodically work through every room.

  • Open every cabinet door and drawer

  • Run every faucet (hot and cold) and flush every toilet

  • Test every electrical outlet with a circuit tester

  • Operate every window (open, close, lock)

  • Turn on every light fixture and fan

  • Run the dishwasher through a cycle

  • Test the garage door opener and safety reverse

Your inspector will be thorough, but two sets of eyes catch more than one. Document everything with photos and detailed notes—even minor cosmetic issues are easier to address before closing than after.

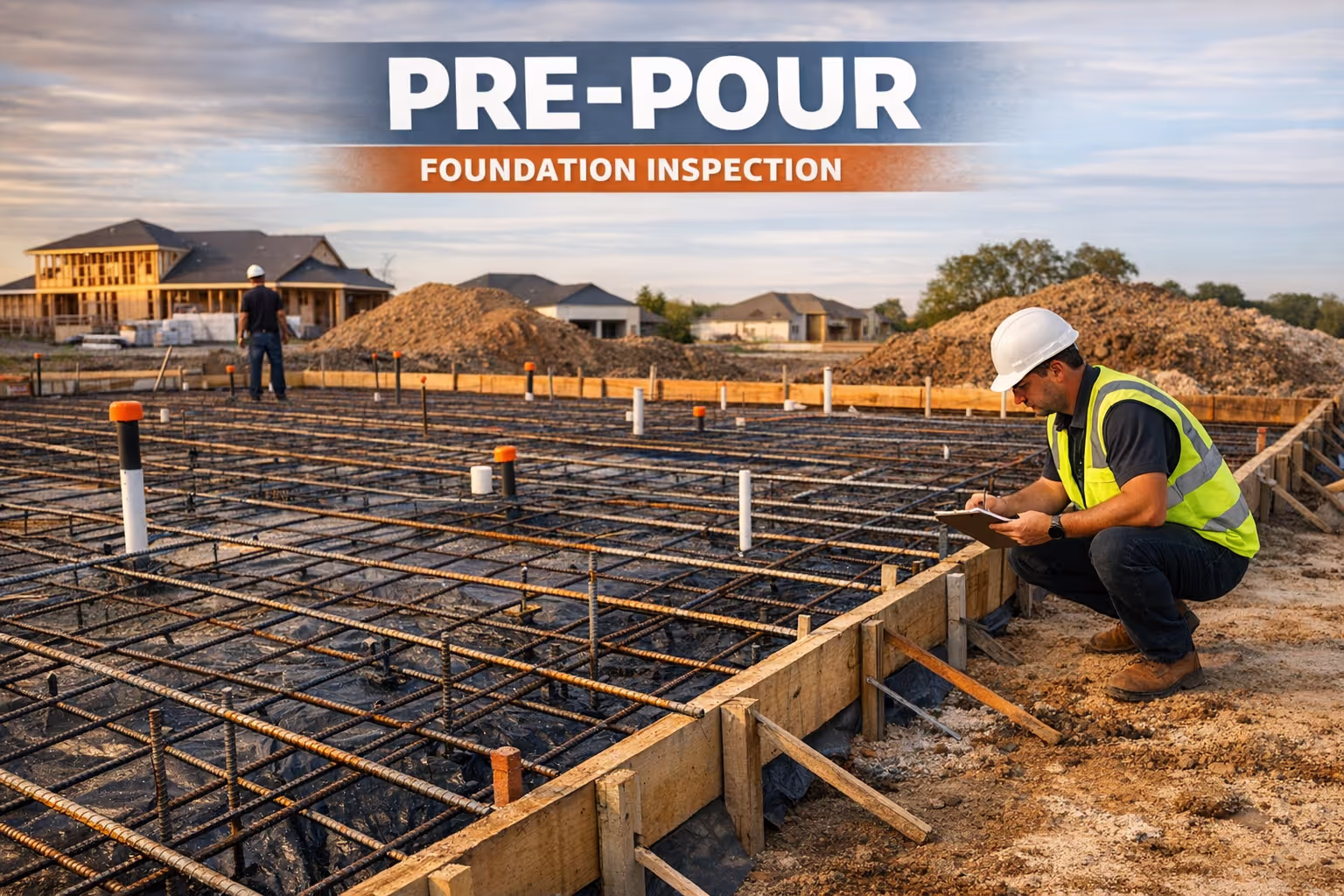

Pre-pour foundation inspection timeline phase with rebar and forms visible
Foundation inspection catches structural issues before concrete pour

Phase Four: The 11-Month Warranty Inspection

Here's the inspection most new homeowners forget about—and it's a costly oversight.

Most new construction homes come with a builder warranty, typically structured with different coverage periods for different components. Many builders offer one year of coverage for workmanship and materials defects [4]. Some structural components may carry longer coverage, but the first year is usually your window for most issues.

Once that coverage period ends, you lose the ability to have covered defects repaired at the builder's expense.

Scheduling an inspection around the 11-month mark gives you time to identify issues, submit warranty claims, and have repairs completed before coverage expires.

What to Look For at 11 Months

After nearly a year of living in your home, certain issues become apparent that weren't visible at closing:

Settling-related issues

  • Drywall cracks (especially at corners, above doors, and at ceiling lines)

  • Doors and windows that no longer close or latch properly

  • Gaps developing at trim joints or where different materials meet

  • Visible cracks in foundation or garage slab

System performance issues

  • HVAC struggling to maintain temperature in certain rooms

  • Unusual sounds from plumbing (water hammer, gurgling drains)

  • Electrical issues (flickering lights, tripping breakers)

  • Water pressure changes since move-in

  • Slow drainage that has developed over time

Exterior concerns

  • Grading that has shifted (water pooling near foundation)

  • Caulking failure around windows and doors

  • Flashing issues that weren't apparent initially

  • Concrete cracks in driveway, walkways, or patios

Pro Tip from Tavon: "I always recommend my new construction buyers set a calendar reminder for month ten of homeownership—not month eleven or twelve. You want buffer time to get the inspection scheduled, receive the report, and submit claims before your warranty window closes. Waiting until the last week is asking for trouble."

Warranty Claim Process

When your inspector identifies warranty-covered items:

  • Document each issue with photos, specific location descriptions, and measurements where relevant

  • Reference your warranty documentation for the required claim submission format and contact information

  • Submit your claim in writing—email creates a timestamp and paper trail

  • Request written confirmation that your claim was received

  • Follow up on repair timelines if you don't hear back within the timeframe specified in your warranty

  • Document completed repairs with photos and confirm in writing that work was done

Some builders handle warranty work promptly and professionally. Others require persistence. Either way, written documentation protects your interests and creates a clear record if disputes arise.

Your Reusable Punch-List Framework

Use this framework to organize findings at each inspection phase. Create a spreadsheet or document with these columns:

For every inspection phase:

  • Location: Specific room and area (e.g., "Primary bathroom, north wall")

  • Issue description: Clear, factual description of the defect

  • Photo reference: Number or filename of supporting photo

  • Priority level: A, B, or C (see classification below)

  • Date reported to builder: When you submitted the item

  • Builder response: Their acknowledgment or repair timeline

  • Date verified complete: When you confirmed the fix

Priority Classification

  • A – Safety or code concern: Address immediately (structural defects, electrical hazards, fire safety issues, code violations)

  • B – Functional issue: Address before closing or within warranty period (systems not working correctly, installation defects affecting performance)

  • C – Cosmetic issue: Address per builder's standard process (paint touch-ups, minor finish work, aesthetic concerns)

Pro Tip: Take photos with your phone's timestamp feature enabled. Include something for scale (a tape measure, your hand, or a coin) when documenting cracks or gaps. Wide shots showing context plus close-ups of specific defects create the most useful documentation.

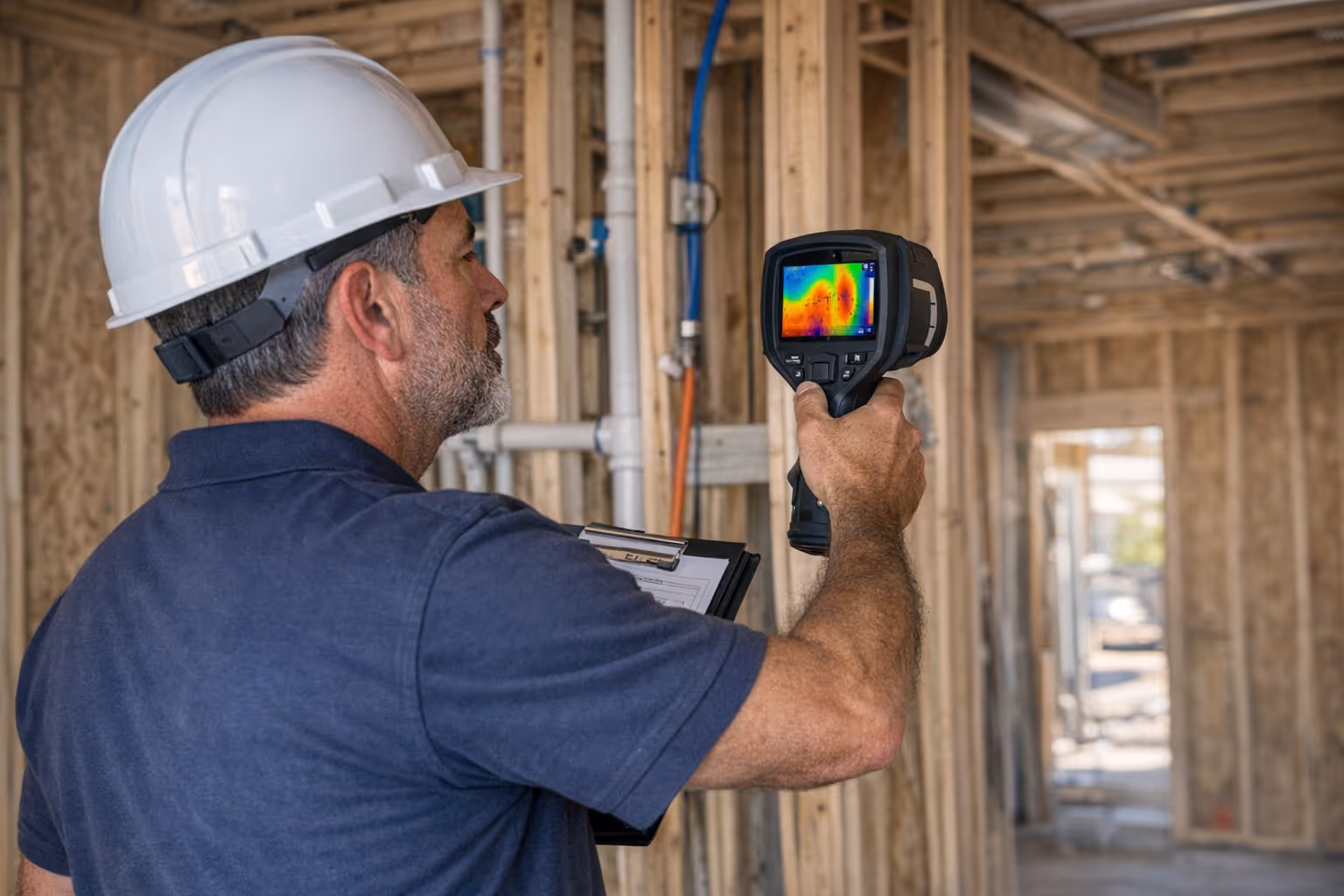

Professional inspector using thermal imaging during new construction inspection timeline
Advanced diagnostic tools identify hidden defects during inspections

How to Choose a New Construction Inspector

Not all home inspectors specialize in new construction. When selecting an inspector for any of these milestones:

Ask about new construction experience

How many new builds have they inspected in the past year? Are they familiar with local building codes and common practices among builders in your area? Experience with the specific builder constructing your home is a bonus.

Verify credentials

Look for inspectors who hold certifications from recognized professional organizations. Many states, including California, require licensing for home inspectors [5]. Verify active license status before hiring.

Request sample reports

A thorough new construction inspection report should be detailed, include numerous photos, and clearly explain each finding in terms a non-expert can understand. Generic or sparse reports suggest a less rigorous process.

Confirm timing flexibility

Pre-drywall and pre-pour windows are often short—sometimes only a day or two. You need an inspector who can adjust their schedule to match your build timeline, even on short notice.

Ask about diagnostic equipment

Inspectors who use thermal imaging cameras, moisture meters, and other diagnostic tools can identify issues that visual inspection alone might miss.

Coordinating With Your Builder

Some builders welcome independent inspections as a sign of an engaged buyer. Others initially push back. Regardless of their reaction, you have every right to hire your own inspector.

Here's how to approach the conversation:

  • Frame inspections as partnership, not adversarial: "I want to catch anything early while fixes are simple—that's better for both of us."

  • Request the build schedule in writing so you can plan inspection timing

  • Ask for the site supervisor's direct contact information for scheduling coordination

  • Provide reasonable notice (48-72 hours when possible, though pre-pour and pre-drywall may require faster turnaround)

  • Be flexible but firm: You're not asking permission—you're coordinating logistics

Most builders ultimately recognize that professional inspections reduce warranty claims and callbacks. The ones building quality homes have nothing to hide.

What Inspections Cost—And Why They're Worth It

New construction inspection costs vary by market, home size, and scope, but here are general ranges:

Inspection TypeTypical Cost Range
Pre-pour foundation$250–$400
Pre-drywall$300–$500
Final walkthrough$400–$600
11-month warranty$350–$500

For approximately $1,300–$2,000 total across all four inspections, you're protecting an investment worth hundreds of thousands of dollars.

More importantly, you're catching problems when they're least expensive to repair. Consider the math: opening a finished wall to fix a plumbing leak might cost $1,500 or more. Having a plumber tighten that same connection before drywall? Maybe $50 in labor if it's even charged separately.

The inspection fee often pays for itself with a single caught defect.

New construction inspection timeline final walkthrough with inspector and homebuyer
Final walkthrough inspection identifies issues before closing day

Create Your Inspection Timeline Now

Once you have your build schedule from the builder, map out your inspection windows:

  • Identify the expected foundation pour date and schedule pre-pour inspection for that window

  • Mark rough-in completion dates for electrical, plumbing, and HVAC—schedule pre-drywall inspection within that window

  • Note your expected closing date and schedule final walkthrough inspection five to seven days prior

  • Set a calendar reminder for month ten of homeownership to schedule your 11-month warranty inspection

Proactive scheduling prevents missed windows and last-minute scrambling. Build relationships with one or two inspectors early so you have reliable contacts when timing gets tight.

Ready to Build Your Inspection Strategy?

If you're purchasing a new construction home in Sacramento or Elk Grove and want guidance on coordinating inspections with your build timeline, let's connect. Understanding when to schedule inspections—and what to prioritize at each stage—is part of the education-first approach to protecting your investment.

Request a consult to discuss your build schedule, inspection timing, and how to navigate the new construction process with confidence.

Frequently Asked Questions

Do I really need a pre-drywall inspection if the city already inspects during construction?

Yes. Municipal inspections verify minimum code compliance at designated checkpoints, but they're not comprehensive evaluations of your home's overall quality. A private inspector examines systems more thoroughly, documents issues with photos and detailed descriptions, and works exclusively in your interest—not the permit process. The scope and focus are fundamentally different.

Builders may initially discourage independent inspections, but as the buyer, you have the right to hire your own inspector. Frame the conversation around catching issues early when repairs are simple and inexpensive. Most builders cooperate once they understand your intent is collaborative rather than adversarial, though some may require scheduling during specific windows.

Builders may initially discourage independent inspections, but as the buyer, you have the right to hire your own inspector. Frame the conversation around catching issues early when repairs are simple and inexpensive. Most builders cooperate once they understand your intent is collaborative rather than adversarial, though some may require scheduling during specific windows.

What happens if I find issues during my 11-month warranty inspection?

Document each issue with photos, specific locations, and clear descriptions. Submit a written warranty claim to your builder following the process outlined in your warranty documentation—email creates a useful timestamp. Keep records of all communication and follow up on repair timelines. The key is addressing everything before your warranty period expires.

How far in advance should I book my inspector for the pre-drywall inspection?

Contact your inspector as soon as you have a build schedule, ideally before construction begins. Establish the relationship early and keep them updated on progress. The pre-drywall window is often narrow—sometimes only a day or two—and having an inspector who already knows your timeline prevents missed opportunities.

Is the 11-month warranty inspection different from a regular home inspection?

It's similar in scope but focuses specifically on issues that emerge after living in the home—settling cracks, system performance problems that developed over time, and defects that weren't apparent at closing. The goal is documenting everything that qualifies for warranty repair before your coverage expires, so the emphasis is on changes since move-in.

About This Guide

This guide was developed with input from Tavon Willis, a California-licensed real estate professional (DRE #02095751) who works with first-time buyers and new construction purchasers in the Sacramento and Elk Grove areas. The information reflects common practices in residential construction and is educational in nature. For specific concerns about your home, your build, or local code requirements, consult with licensed inspectors, contractors, and other qualified professionals in your area.

Cited Works

[1] National Association of Home Builders — "Labor Shortages." https://www.nahb.org/news-and-economics/industry-news/labor-shortages

[2] International Code Council — "Building Department Administration." https://www.iccsafe.org/

[3] National Fire Protection Association — "NFPA 70: National Electrical Code." https://www.nfpa.org/codes-and-standards/nfpa-70-standard-development/70

[4] Federal Trade Commission — "Home Warranties." https://consumer.ftc.gov/articles/home-warranties

[5] American Society of Home Inspectors — "State Licensing and Regulations." https://www.ashi.org/

Related Posts

Tavon Willis | Footer
